Designeers

Time Span
June 1, 2024
June 30, 2025
Client
Designeers
Project Type
SEO
My Role
SEO Consultant
Tools
Semrush
Google Analytics
Ahrefs
Google Search Console
Nabil Butt

Project Background

Problem Statement

Designeers, a global digital media platform for interior design, had near-zero organic visibility despite a rich content library. With ~23 impressions/day, 0 ranked keywords, rampant 404 errors and pages loading at 40MB, the platform's Black Book membership directory — its core revenue driver — was effectively invisible in search.

Project Goals

Transform Designeers from a static publication into a discoverable platform by fixing technical foundations, optimising on-page content, and equipping the editorial team with sustainable SEO workflows to support long-term Black Book growth.

Background Context

Designeers features editorial stories, designer profiles and destination guides for an audience that values high-quality interiors. Search visibility directly fuels its paid Black Book directory. The site ran on Squarespace, which imposed platform constraints that required creative technical solutions throughout the project.

The Process

Website Audit

A comprehensive technical, on-page and off-page audit using Screaming Frog, Semrush, Google Search Console and Google Analytics revealed critical barriers preventing organic visibility. The platform suffered from severe technical debt: approximately 23 new 404 errors daily stemming from broken redirect chains and URL restructuring without proper canonical implementation, creating duplicate content issues across hundreds of pages.

On-page analysis exposed systemic content optimisation gaps. Auto-generated metadata with no keyword targeting, missing alt text on featured designer imagery, and random slug structures severely hampered discoverability. Pages loaded 8-10 uncompressed images averaging 40MB total, resulting in Core Web Vitals failures especially on mobile devices where editorial content is primarily consumed.

Competitive Analysis & Keyword Mapping:

Competitive analysis against Dezeen, Architectural Digest and similar design platforms revealed 132,600+ keyword gaps representing missed opportunities across designer profiles, city guides and editorial content. This informed a three-tier content hierarchy strategy: Journal articles targeting informational keywords, Black Book profiles optimising for designer discovery, and Marketplace content capturing transactional intent across furniture and lighting categories.

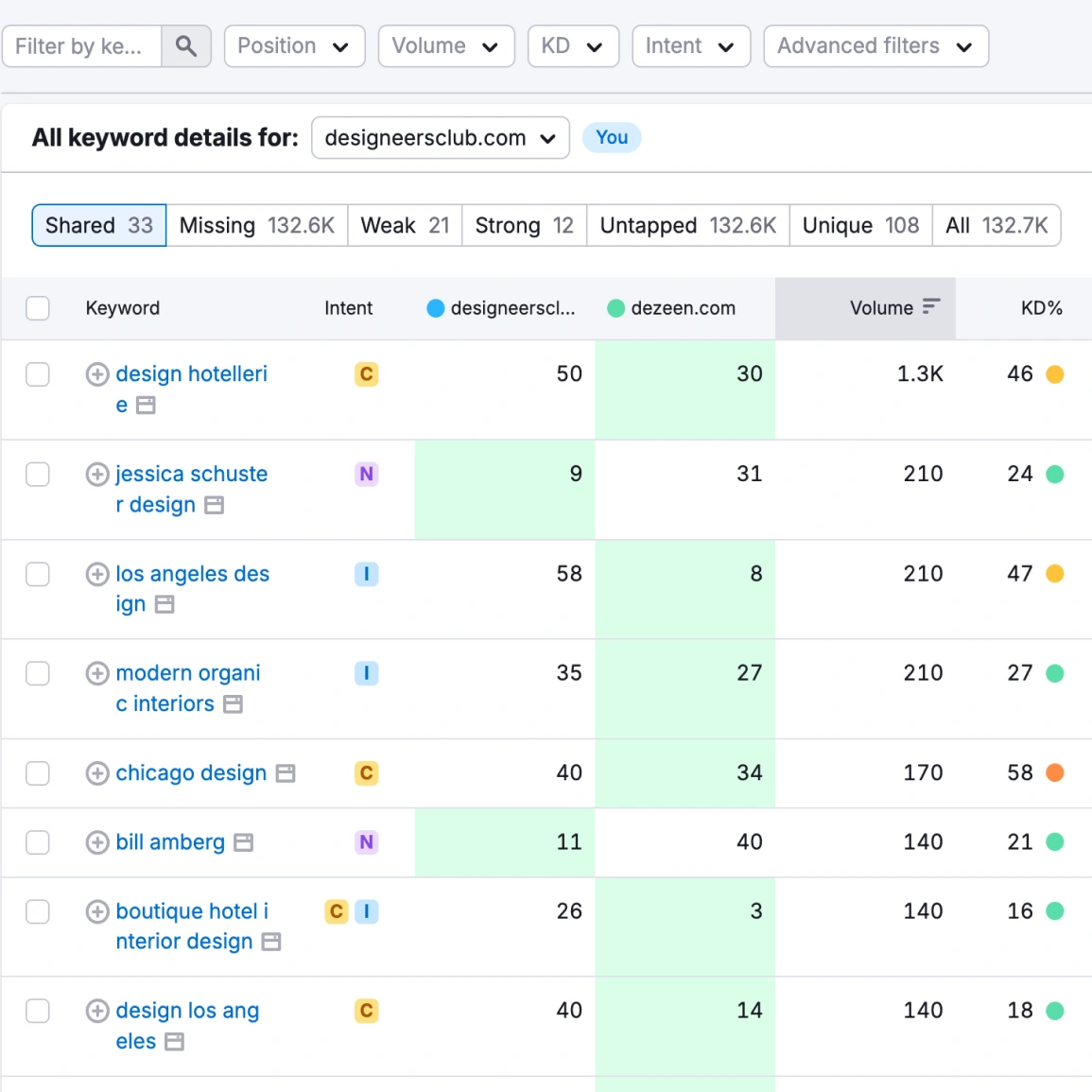

Keyword gap analysis comparing Designeers vs Dezeen showing 132.6K missing keyword opportunities including design hoteliers, interior designers, and destination guides

SEO Strategy & Roadmap

A phased roadmap structured the engagement across four strategic milestones spanning 13 months. Discovery & Alignment established baseline visibility benchmarks and secured technical access. Technical SEO & Recovery prioritised foundation repair through systematic 404 resolution, canonical tag implementation, and structured data deployment using JSON-LD.

Content Optimisation & Authority Building:

Content & Optimisation expanded keyword mapping across all content categories, implementing unique targets for each page type. Off-page initiatives included Google My Business setup and backlink generation through design publication partnerships. Monitoring & Enablement focused on performance analysis and comprehensive handover documentation.

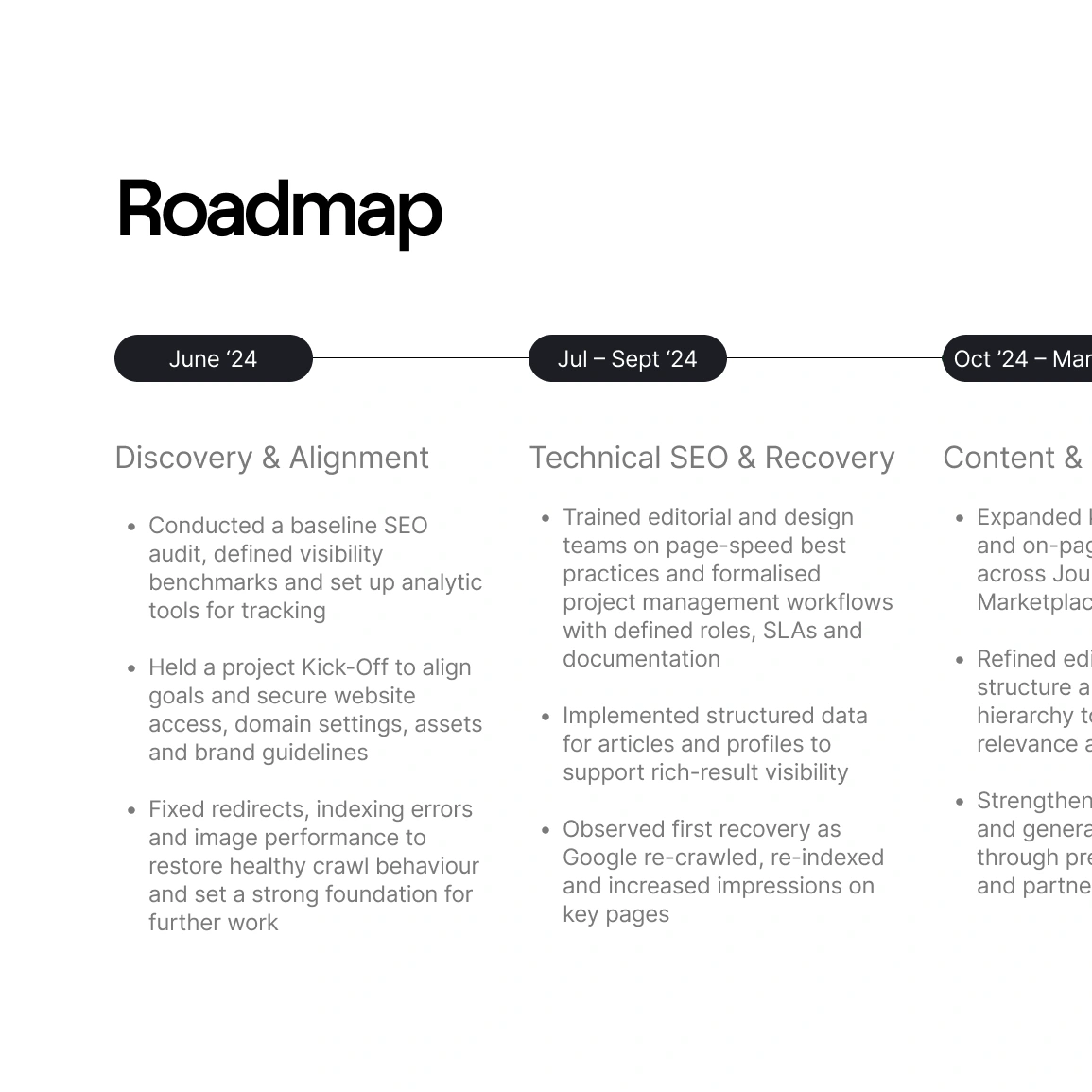

SEO project roadmap for Designeers showing four phases: Discovery & Alignment, Technical SEO & Recovery, Content & Optimization, and Monitoring & Enablement from June 2024 to July 2025

Monitoring & Iteration

Performance tracking via Google Search Console and Google Analytics revealed recovery patterns as Google progressively re-crawled and re-indexed corrected pages. Impressions on priority articles and Black Book profiles began recovering within 4-6 weeks of technical fixes, validating the foundation-first approach over premature content optimisation.

Data-Driven Refinement:

GSC query analysis identified high-impression, low-click-through opportunities where title tag and meta description refinements could capture additional traffic. Pages ranking positions 8-15 received priority treatment through enhanced snippet optimisation, while designer profile pages benefited from structured data implementation enabling rich result eligibility in search features.

Continuous Improvement Process:

Monthly performance reviews with the Designeers team analysed ranking fluctuations, traffic patterns and user behaviour trends. High-performing content formats informed editorial calendar planning, whilst underperforming sections received diagnostic review addressing technical barriers, keyword misalignment or content quality gaps. This iterative approach established feedback loops ensuring sustained month-over-month growth beyond the engagement period.

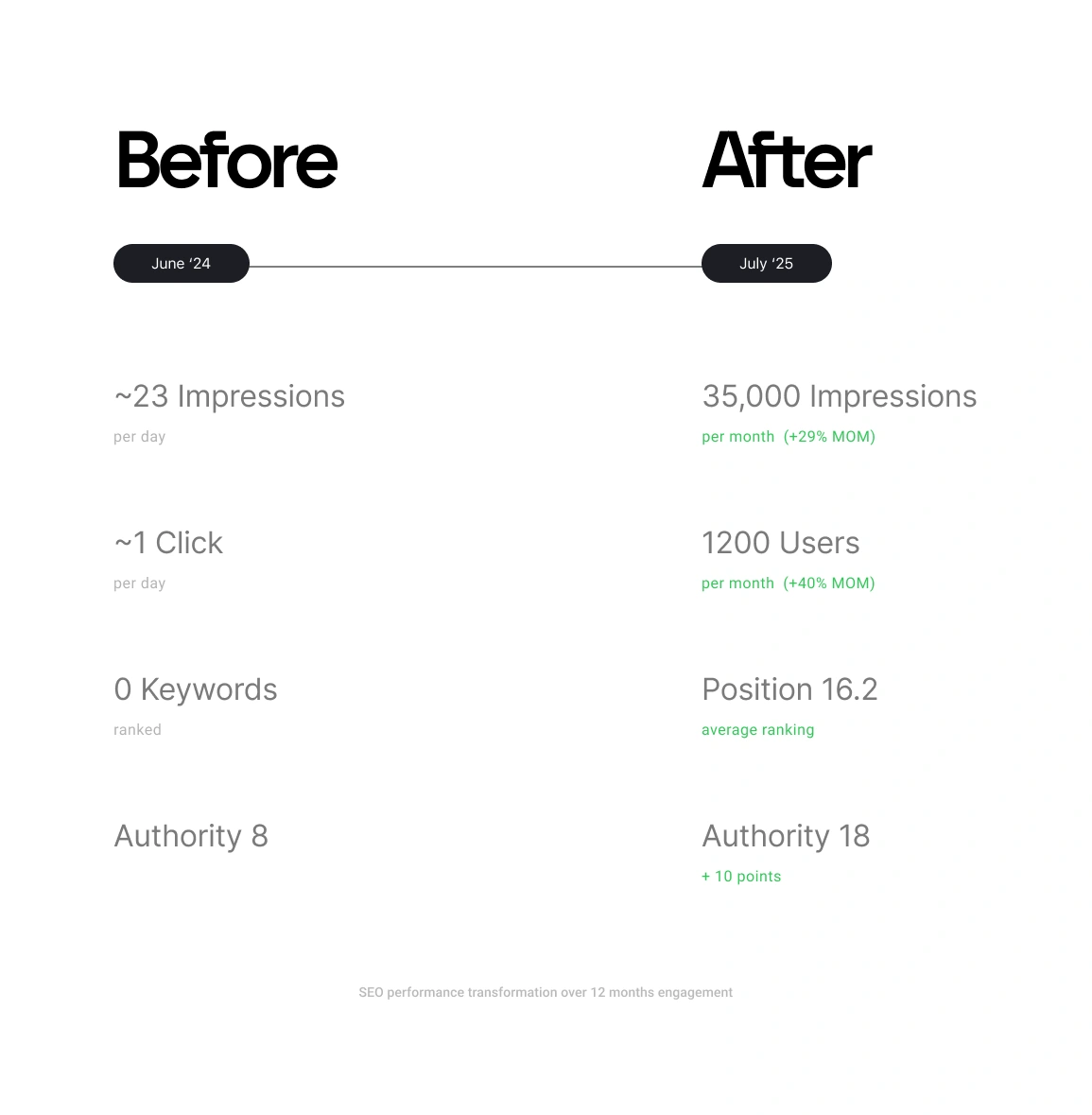

Designeers SEO performance transformation showing growth from 23 daily impressions to 35,000 monthly impressions and website authority increase from 8 to 18 over 12 months

Solution

Implementation

Technical SEO: Fixed 404 errors, implemented 301 redirects, resolved canonical tag issues and deployed structured data (JSON-LD) for article and profile pages to support rich results.

On-Page SEO: Rewrote title tags and meta descriptions across all page types, mapped unique keyword targets, and added keyword-rich alt text with guided internal linking.

Off-Page & Authority: Set up Google My Business profile for digital publication presence, created media kits with ready-to-use assets for contributor outreach, and secured high-quality backlinks from design publications to strengthen domain authority.

Team Enablement: Trained the editorial and design teams on image optimisation, Monday.com SEO workflows and content best practices — ensuring improvements would hold after project completion.

Designeers mobile website showing optimized Destination Guides page with curated design city content for New York, Dubai, Los Angeles, and Amsterdam following SEO improvements for enhanced mobile discoverability
No items found.

Final Thoughts

The project transformed Designeers into a consistently growing, discoverable platform. Organic visibility improved month over month, giving the Black Book directory and editorial features lasting reach—directly supporting the platform's core revenue model by making designer profiles and premium content accessible to design professionals searching for inspiration and collaboration opportunities. Despite Squarespace's platform constraints, the technical foundation built during this engagement proved both resilient and scalable. The structured data implementation, canonical tag architecture, and image optimisation workflows established systems that continue to support growth without constant technical intervention. More importantly, the comprehensive team training ensured the editorial and design staff could maintain SEO quality standards independently, preventing the technical regression that often follows consultant handovers. The SEO strategy handover documentation equipped the Designeers team to sustain momentum beyond the engagement period. By embedding SEO principles into Monday.com workflows and establishing clear content guidelines, the project delivered not just improved rankings, but a sustainable competitive advantage in the crowded design media landscape.
